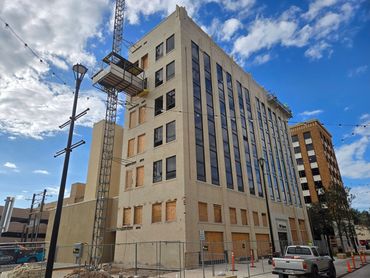

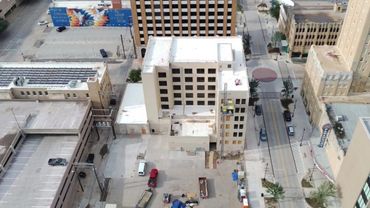

9/14/2026
Landmark on Cypress continues to make strong progress! Exterior brick restoration is underway, including scraping, painting, new door openings, and brick replacement, while new windows are being installed throughout the building. Inside, work is progressing across all six floors with electrical, plumbing, HVAC, insulation, gypsum board, ceiling framing, and plaster work underway. Crews are also continuing to clean and organize the site as the historic building moves steadily toward completion.
7/23/2026

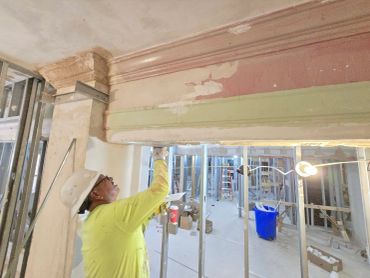

Another productive few weeks are in the books as work continues to move steadily throughout the building! Crews have completed fire wall sheetrock through the seventh floor, mud and tape on floors 3–7, first-floor plumbing and electrical inspections, and significant progress on plumbing, HVAC, and electrical rough-ins. Interior finishes are also taking shape with crown molding installation underway, while EIFS installation at the main entry has been completed to enhance the building's exterior.

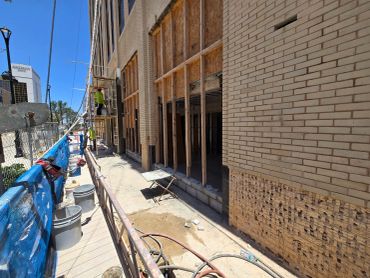

Outside, brick restoration continues to make great progress with multiple sections completed on both the north and west elevations as crews prepare to move swing stages to the next work areas. In the coming weeks, teams will continue plumbing, electrical, and HVAC rough-ins, install exterior wall sheetrock on floors 3–7, complete CMU corridor walls to support plaster work, and continue masonry improvements as this historic renovation keeps moving forward.
6/4/2026

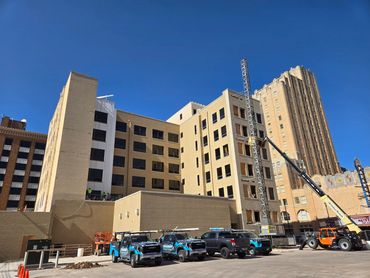

Over the past month, significant progress has been made at Cypress as construction continues to move forward throughout the building. Early work included completion of the first-floor under-slab plumbing, elevator demolition, roof replacement activities, floor sanding, and site concrete preparations.

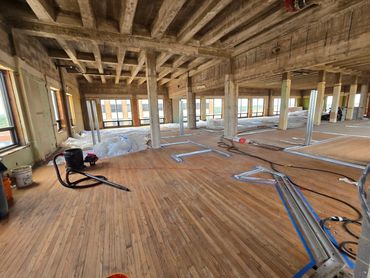

More recently, crews completed the first-floor terrazzo installation, advanced plaster restoration on upper floors, and continued framing work throughout the building, with the sixth floor now complete and first-floor framing underway. Exterior brick restoration continues to make excellent progress, with swing stages now in place to support work higher on the building. Mechanical, electrical, and plumbing trades are actively installing infrastructure, including ductwork, electrical panels, and shower units on multiple floors.
4/20/2026
The team continues to make steady progress at Landmark on Cypress as multiple phases of work move forward across the building. Demolition is now complete through the 7th floor, including roof demo, while abatement on the upper levels is wrapping up in sections. Framing has advanced through the lower floors, and wood floor restoration is well underway with sanding and staining completed on several levels and continuing upward. Underground infrastructure has also seen major movement, with plumbing installed, tested, and backfilled in key areas, along with trenches poured and utility work completed to support future phases.
Site improvements are also taking shape with the transformer pad poured and additional concrete work in progress around utilities. Crews are preparing for the next stage by finalizing under slab plumbing on the first floor, continuing floor sanding on upper levels, and progressing toward core drilling for vertical plumbing runs. Upcoming work will also focus on completing remaining roof and elevator demolition, ensuring the building is fully prepped as structural, mechanical, and finish work continue to ramp up.
